A Pretty Accuracy Number Hid Dozens of Money-Moving Errors — How to Read the Eval to Ship

I ran the money-moving scenario for a retail customer-service agent: refunds, cancels, address changes, shipment interceptions, the writes that move real money. At the launch review, the vendor brought a pretty overall accuracy and asked to roll out. Was that number enough to ship on? What was sitting inside it?
The moment I pulled the money-moving intents out, the number was ugly. Their wrong-action rate was alarming. Dozens of money-touching errors had been there the whole time, diluted into tens of thousands of harmless "where's my order" rows. The pretty total looked fine. The money-moving errors were hidden by one blended number. A vague accuracy or self-serve rate is the best hiding place for errors that lose money.
The earlier pieces already covered which rows to sample, how many to label, and how reliably those labels are made. This one is the last step: turning labeled samples into a launch decision that does not fool you. This is the step where people trip.
Money-moving errors need their own gate
A launch decision cannot ride on one blended number. Money-moving writes have to be pulled out on their own, watched by their wrong-action rate, at a far stricter threshold than consult intents.
Why a total lies: not because money-moving writes are some precise sliver of all traffic. The sampling piece is about what you miss if you pick samples by frequency. Top utterances — product questions, order-status checks, greetings — show up constantly. Refunds, small compensations, and the money-moving cases the system answers poorly behave more like a long tail: draw by how often a line appears, and they stay out of the labeled set. In real traffic, refunds and small compensations are actually large in volume; do not write this as "a fraction of a percent of all traffic." The same trap shows up in a launch decision. Mix money-moving intents with those high-frequency, easy conversations into one accuracy number, and the errors get covered up. You nod at a 95% overall, while the wrong refunds and mishandled compliance cases were never pulled out and watched on their own.
A wrong consult answer, and the customer asks again. A wrong money-moving action, and real money is lost, maybe in a compliance incident. So money-moving intents get their own track and their own gate, watched not on accuracy but on the wrong-action rate: the share of conversations where a money-moving action was executed incorrectly. The threshold is set at zero tolerance. The hard red line is mis-execution must be zero: one occurrence fails the gate. That hard line is not a confidence interval pressed down to zero. The soft thresholds are judged on the interval bounds: accuracy at least 90%, self-serve rate at least 65%, false-reject rate at most 5%. Those soft thresholds are a launch-evaluation method, not year-round handover targets hung on accuracy, self-serve rate, or false-reject rate.

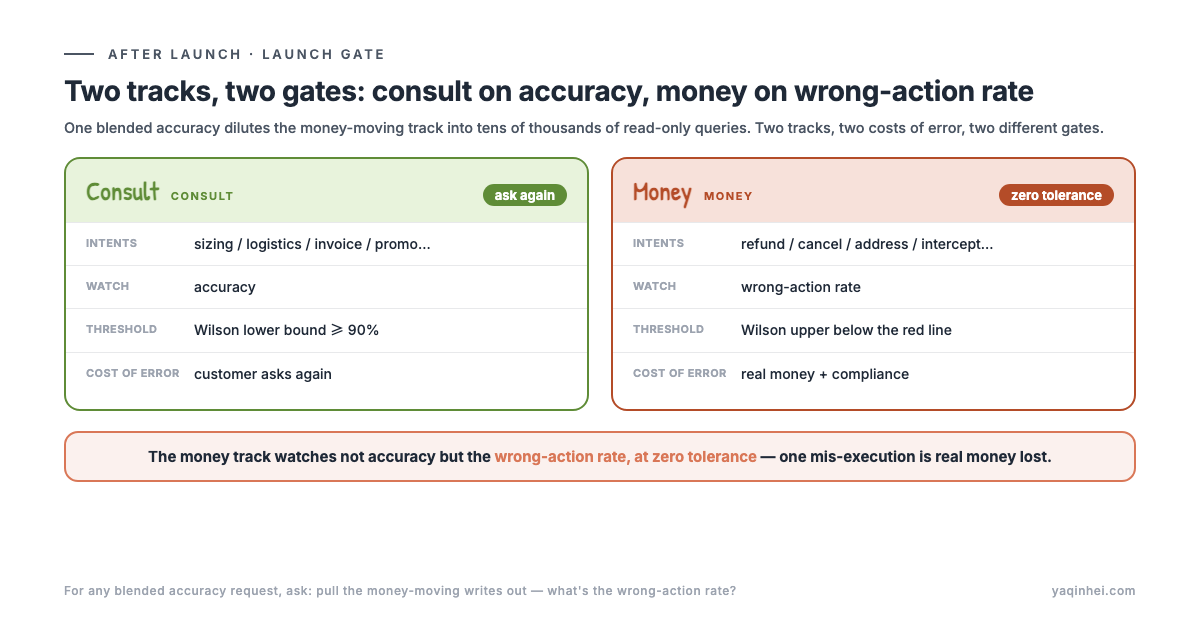

One blended accuracy dilutes a crash on the money-moving track into tens of thousands of read-only queries. Two tracks, two costs of error, must have two different gates.
Whenever someone requests a launch with a blended accuracy or self-serve rate, ask one thing: pull the money-moving writes out on their own, what's the wrong-action rate? If they cannot say, or never computed it separately, the request cannot be approved.
Some of those dozens of errors are old debt from before the fix
Ready is not whether the point estimate cleared. It is whether the confidence-interval bound clears the threshold. You also have to cut pre-fix old data per scenario, or you cannot see the current true level, nor prove the fix worked.
Those dozens of errors hide one more trap. Some of them are old wrong answers left by the bug you just fixed last week. Accuracy is correct divided by total. If the denominator still holds pre-fix old debt, an already-fixed agent gets dragged to "not ready" by its own history. You either block an agent that should ramp, or you cannot tell whether the fix did anything.
The remedy is a per-scenario version cut. A scenario that got a bug fix has its pre-fix data cut from the denominator, only that scenario, nothing else touched. A global cut would delete valid labels from unaffected scenarios. A surgical cut washes out the old debt without collateral damage. Then layer the Wilson confidence interval on top, not the point estimate.
On the money-moving track, you watch mis-execution: in a given channel, after that scenario's latest fix, one conversation that executed a money-moving action incorrectly means the hard red line has not cleared. The verdict is a count of zero, not a confidence-interval upper bound pressed down to zero. Accuracy, self-serve rate, and false-reject rate on the consult side are the soft thresholds: those are judged on whether the interval bounds clear, not on the point estimate. Accuracy looks at whether the lower bound is at least 90%, self-serve rate whether the lower bound is at least 65%, and false-reject rate whether the upper bound is at most 5%.
For anyone who has to implement the calc, the spoken rule above can be written as:
mis_execution_count(money_intent, channel) must be 0
where convo.time ≥ that scenario's latest fix version-cut # cut old debt per scenario, nothing else
verdict: one mis-execution fails. Soft thresholds use the Wilson bound # hard line is a count; soft gates use the interval
Ask: does this accuracy's denominator cut pre-fix data? Global, or per-scenario?
Launch is not a one-shot ship. It is a progressive rollout
A launch decision's output is not ship or not. It is which channel, at what volume. Each channel is gated on its own, and ramped only when it clears.
Launch is not a switch. It is a rollout curve: 10% canary, then 50%, then full, each step its own gate. As the sampling piece noted, the channel is a real variable in accuracy. A private channel clearing does not mean the public channel also clears. So the rollout is per channel.
If a channel has had even one money-moving mis-execution, do not ramp it; go fix the agent. Soft thresholds have to clear too: accuracy lower bound at least 90%, self-serve lower bound at least 65%, false-reject upper bound at most 5%, before you ramp to the next step. If the interval still straddles those soft thresholds and there is no conclusion yet, hold this step and keep labeling until you can decide.
For implementers, the per-channel rule can be written as:
for channel in channels:
if money-moving mis-execution count > 0: → don't ramp, go fix the agent
elif accuracy lower bound ≥ 90% and self-serve lower bound ≥ 65% and false-reject upper bound ≤ 5%:
→ ramp to the next step (10%→50%→full)
else: → hold this step, keep labeling toward a conclusion
The worst case is then just one channel stuck at 10% canary, not one pretty total pushing all channels to full together and then crashing on some channel's money-moving intent.
Start by pulling the money-moving track out
These three moves can happen this week. Pull the money-moving writes out of the total and compute the wrong-action rate on their own; any blended accuracy or self-serve rate should be split into money-moving and consult first, with money-moving watched on mis-execution, and the hard red line set at zero. Do a per-scenario version cut on the denominators for accuracy, self-serve rate, and false-reject rate: for scenarios that got a fix, cut pre-fix data from the denominator, only that scenario, and judge the soft thresholds on the Wilson lower or upper bound, not the point estimate. Turn launch into a per-channel progressive rollout. Do not push full with one total in one shot. Each channel is gated on its own. The hard red line clears first, the soft-threshold interval bounds also clear, and only then do you ramp that channel, from 10% to 50% to full.
A launch decision is not a score for the agent. It answers a harder question: at which channel, at what volume, how confident am I that it will not crash where money moves. Split it into four things: a gate of its own for wrong actions, a lower bound, a cut of old debt, and a per-channel ramp. Then you finally have a gate that does not fool you.
Which rows, how many, how reliably labeled, how to judge launch: this after-launch mechanism now closes a loop that honestly measures an agent. But launch is only the beginning. An agent that clears today can quietly slide six weeks later. I wrote about that separately, in Your Dashboards Are Green While the Agent Quietly Gets Dumber: how to notice it before the agent gets dumb, while the dashboards are still green.
If this turned your launch decision from nodding at one total into a wrong-action gate of its own, a lower bound, a cut of old debt, and a per-channel ramp, send me the keyword "RAMP KIT" and I will share the money-moving dual-track gate, the per-scenario cut, and the progressive rollout template.
